Ground Floor Room Addition in Chula Vista for Aging Parents: Cost, Design, & Permit Guide

A ground-floor room addition in Chula Vista designed for aging parents provides a safe, accessible, and independent living space while keeping multi-generational families connected under one roof. Building an attached ground-floor parental suite or Accessory Dwelling Unit (ADU) in Chula Vista typically costs between $250 and $450 per square foot, with total project budgets ranging from $150,000 to $350,000 depending on total square footage, structural complexity, and luxury finish selections. Under California state legislation (such as Assembly Bills 976 and 2221) implemented by the City of Chula Vista Development Services, building permit reviews are legally capped at a maximum 60-day turnaround. Furthermore, additions under 750 square feet are completely exempt from local development impact fees. To support long-term mobility and safety, these additions prioritize Universal Design standards, including zero-step entries, 36-inch wide door frames, roll-in showers, lever hardware, and slip-resistant flooring.

Comparing Ground-Floor Living Options for Aging Parents in Chula Vista

When expanding a home to accommodate elderly family members, homeowners in Chula Vista generally choose between three primary structural layouts: an attached ground-floor room addition, a garage conversion Junior Accessory Dwelling Unit (JADU), or a detached granny flat. The optimal choice depends on lot size, existing property geometry, budget constraints, and the desired degree of independent living.

Attached Ground-Floor Room Addition

An attached ground-floor addition extends the existing foundation and roofline of the primary home. This configuration creates a seamless transition between the main house and the new parental suite. It allows aging parents to remain connected to shared family spaces—such as the kitchen and main living room—while offering a private bedroom and accessible bathroom.

Garage Conversion JADU

Converting an attached garage into a Junior ADU (up to 500 square feet) utilizes an existing foundation and framing envelope. This option reduces structural framing costs while keeping the suite on the ground floor. However, it requires extensive insulation, concrete slab leveling, utility retrofitting, and loss of covered vehicle parking.

Detached Ground-Floor ADU

A detached ADU is an entirely independent single-story structure built in the yard. While providing maximum privacy and full independent amenities (such as a full kitchen and laundry), detached builds require independent utility trenching, greater setback clearances, and higher overall construction budgets.

Comparison Matrix: Ground-Floor Addition Configurations

Structural Feature Attached Ground-Floor Addition Garage Conversion (JADU) Detached Ground-Floor ADU
Typical Size Range 300 to 800 sq ft 300 to 500 sq ft 500 to 1,200 sq ft
Estimated Cost Range $150,000 – $280,000 $90,000 – $160,000 $220,000 – $380,000+
Construction Timeline 4 to 7 months 3 to 5 months 6 to 9 months
Impact Fee Exemption Fully exempt (<750 sq ft) Fully exempt (<750 sq ft) Exempt if under 750 sq ft
Accessibility Potential Excellent (Custom flush floor transitions) Moderate (Requires floor leveling) Excellent (Custom ground-level slab)
Privacy Rating High (Shared wall with internal door) Moderate (Adjacent to driveways) Maximum (Separate structure)

Universal Design Essentials for Aging-in-Place Additions

Integrating Universal Design into a ground-floor addition ensures the space remains functional, safe, and comfortable as physical mobility changes over time. Incorporating these features during initial construction avoids costly retrofits later.

  • 36-Inch Doorway and Hallway Clearances: Standard interior doors measure 28 to 30 inches wide. Expanding door frames to a minimum of 36 inches (and hallways to 42–48 inches) allows smooth passage for walkers and wheelchairs.

  • Zero-Step Thresholds: Flush threshold entries eliminate tripping hazards at exterior doors and interior transitions between hardwood, tile, and carpet.

  • Curbless Roll-In Showers: Eliminating the standard 4-inch shower curb prevents falls. Showers should include linear drains, built-in teak or tiled benches, handheld showerheads, and thermostatic mixing valves to prevent scalding.

  • Structural Wall Blocking for Grab Bars: Installing 2×10 solid wood blocking behind drywall around toilets and shower walls ensures grab bars can support up to 500 pounds of weight safely.

  • Ergonomic Hardware and Fixtures: Round door knobs and twist faucets are replaced with lever-style handles, rocker light switches, and touchless or pull-down kitchen faucets.

  • Task Lighting and Dimmers: Aging eyes require higher illumination levels. Installing anti-glare recessed LED lighting (3000K–3500K color temperature), low-level nightlights, and illuminated rocker switches reduces fall risks during nighttime navigation.

  • Slip-Resistant Flooring Material: High-durability materials with a dynamic coefficient of friction (DCOF) rating above 0.42—such as slip-resistant luxury vinyl plank (LVP) or matte-finish porcelain tile—prevent slipping in wet areas.

For detailed guidance on accessible design standards, consult the official AARP Livable Communities Guide.

Chula Vista Zoning Rules, Permitting Requirements, and Building Codes

Navigating local municipal codes is critical to ensuring a ground-floor room addition complies with city guidelines and California state housing laws. According to the California Department of Housing and Community Development (HCD), state mandates streamline local approvals to encourage multigenerational housing solutions.

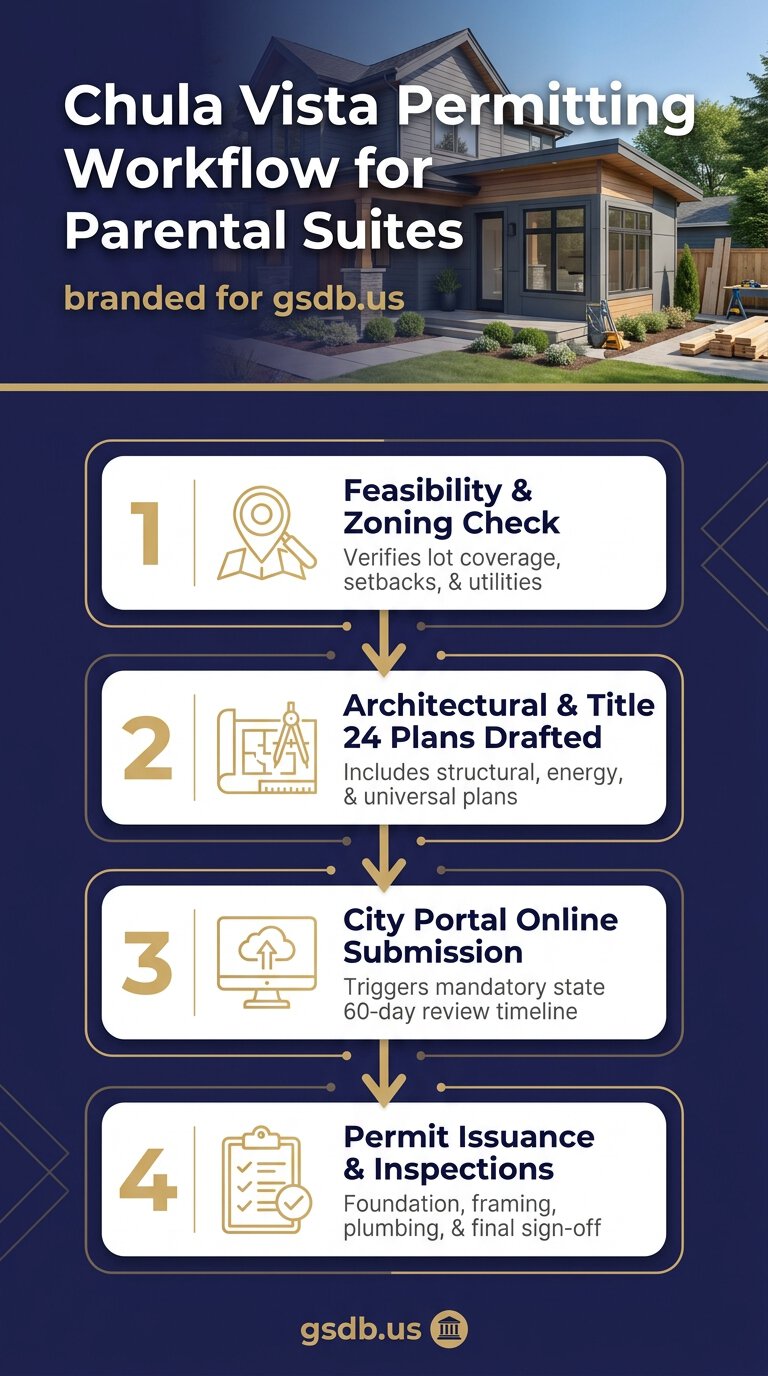

Chula Vista Permitting Workflow for Parental Suites

Key Regulatory Factors in Chula Vista

  • Mandated 60-Day Review Window: Under California Assembly Bill 976, the City of Chula Vista must act on completed ADU and room addition applications within 60 days of submittal.

  • Setback Requirements: Standard attached ground-floor room additions must maintain standard underlying single-family zone setbacks (typically 5 feet for side yards and 15–20 feet for rear yards). However, attached or detached ADU additions require reduced minimum side and rear setbacks of just 4 feet.

  • Maximum Allowable Size: Attached ADU additions can measure up to 50% of the existing primary home’s floor area, up to a maximum of 850 square feet for 1-bedroom units or 1,000 square feet for 2-bedroom units. Standard primary room additions are governed by total parcel lot coverage maximums (typically 40% to 50% in standard Chula Vista residential zones).

  • Development Impact Fee (DIF) Exemption: Additions and ADUs under 750 square feet are exempt from local city impact fees, saving homeowners between $5,000 and $12,000 in municipal development fees.

  • California Title 24 Energy Standards: All room additions in Chula Vista must meet strict energy efficiency compliance, requiring high-efficiency heat pump HVAC systems, LED lighting, dual-pane low-E windows, and properly rated wall/ceiling insulation (R-15 to R-38).

Detailed Cost Breakdown for a Chula Vista Ground-Floor Addition

Building an aging-in-place suite requires careful allocation of funds between core structural elements and custom accessibility finishes. Below is a realistic budget breakdown for a typical 500-square-foot ground-floor parental suite in Chula Vista.

Budget Allocation Table: 500 Sq. Ft. Parental Suite

Construction Category Cost Breakdown Range Average Cost Percentage of Total Budget
Architectural Design & Permits $8,000 – $15,000 $11,500 5% – 7%
Site Prep, Excavation, & Foundation $20,000 – $35,000 $27,500 12% – 15%
Framing, Roofing, & Exterior Siding $35,000 – $60,000 $47,500 20% – 25%
Plumbing, Electrical, & HVAC (Heat Pump) $25,000 – $45,000 $35,000 15% – 18%
Drywall, Insulation, & Painting $12,000 – $22,000 $17,000 8% – 10%
Universal Bathroom (Curbless/Roll-in) $18,000 – $32,000 $25,000 10% – 14%
Doors, Windows, LVP Flooring, & Trim $15,000 – $28,000 $21,500 9% – 12%
Cabinetry, Fixtures, & Safety Hardware $10,000 – $20,000 $15,000 6% – 8%
Total Estimated Investment $143,000 – $257,000 $200,000 100%

Step-by-Step Construction Process for a Multi-Generational Addition

Executing a ground-floor addition requires seamless collaboration between designers, structural engineers, and licensed general contractors. Working with experienced residential specialists like Golden Shore Design and Build ensures the project meets both stringent local building codes and custom accessibility requirements.

  1. Initial Property & Structural Feasibility Check: Site assessment evaluates parcel boundary lines, existing electrical panel capacity (minimum 200-amp service recommended), sewer lateral depth, and setback measurements.

  2. Universal Design Drafts & Title 24 Engineering: Designers craft custom floor plans prioritizing open sightlines, wide turning radiuses (minimum 60-inch turning circle for wheelchairs), and energy compliance calculations.

  3. Plan Submittal & City Review: Architectural blueprints, structural calculations, and soils reports are uploaded to Chula Vista’s Accela online portal for city plan check review.

  4. Foundation & Structural Concrete Framing: Ground excavation begins, followed by pouring a reinforced concrete slab with integrated zero-step doorway depressions.

  5. Utility Rough-Ins & Structural Inspection: Plumbing lines, electrical wiring, low-voltage safety wiring, and HVAC ductwork are installed prior to framing wall insulation and sheetrock closure.

  6. Accessible Finish Installation: Specialized crew members install curbless shower pans, waterproof membranes, non-slip flooring, wide doors, grab bar backing, and emergency alert systems.

  7. Final City Inspection & Certificate of Occupancy: City building inspectors conduct a comprehensive walkthrough to verify structural safety, plumbing function, Title 24 energy compliance, and egress requirements.

Frequently Asked Questions

What is the average cost per square foot for a ground-floor room addition in Chula Vista?

In Chula Vista, a ground-floor room addition generally costs between $250 and $450 per square foot. Projects that include complex plumbing additions (such as full accessible bathrooms or kitchenettes) typically sit at the higher end of this range due to specialized fixture costs, underground drainage trenching, and waterproofing requirements.

How long does the Chula Vista permit review process take for an aging-in-place addition?

Thanks to California streamlining laws (AB 976), the City of Chula Vista is mandated to complete plan reviews for qualifying additions and ADUs within 60 days of receiving a complete application package. Overall project timelines—from initial design concepts through city approval and final construction—average between 6 and 10 months.

What are the minimum setback requirements for a ground-floor room addition in Chula Vista?

Standard room additions must adhere to base zone setbacks, usually requiring 5-foot side yards and 15 to 20-foot rear yards. However, if the room addition is designed as an attached Accessory Dwelling Unit (ADU), local zoning permits reduced setbacks of 4 feet from rear and side property lines.

Do additions under 750 square feet pay development impact fees in Chula Vista?

No, room additions and ADU builds under 750 square feet are fully exempt from local city development impact fees (DIFs). Additions measuring 750 square feet or larger incur impact fees calculated proportionally to the size of the primary residence.

Will adding a ground-floor parental suite trigger a full property tax reassessment?

No, under California law, adding square footage to your existing residence does not trigger a complete reassessment of your entire property. Instead, the local county assessor performs a “blended” reassessment, adding value based solely on the market value of the new square footage while keeping the tax base of your existing home intact under Proposition 13 limits.
